The intermodal transfer sites approved last decade through the Connect Oregon funding process are in the news this week.

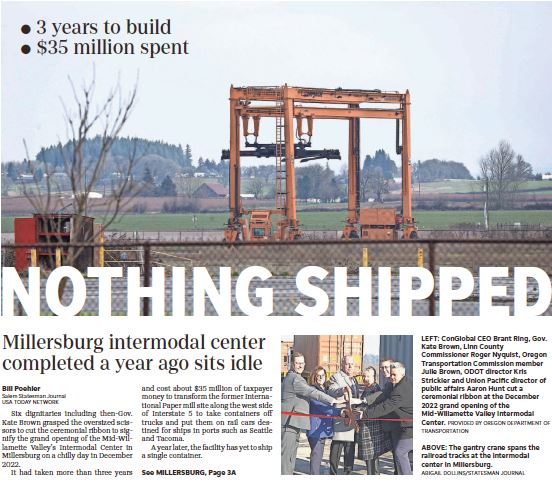

The best story is the latest one at Capital Chronicle, "Behind schedule, over budget, state-backed rail projects costing $70 million sit idle." It benefits from a statewide perspective with important reporting from eastern Oregon that elevates it from merely a local matter, though it is also that.
One small detail in their story that was good to see was that they mentioned opportunity cost:
the Legislature approved $25 million for a Willamette Valley rail center and $26 million for one in eastern Oregon through House Bill 2017, a $5.3 billion package of taxes and fees to fund transportation over the next decade. The bill allocated the money through a grant program called Connect Oregon, overseen by the state transportation department. To receive a Connect Oregon grant, applicants must show that their project can reduce transportation costs for Oregon businesses and connect elements of the state’s transportation system to boost efficiency. In comparison, with $51 million, the state could have invested in more than 120 electric buses or 1,200 rapid charging stations for electric vehicles....
There are several kinds of things to which the funding would have
been better directed, and the focus on climate action is clarifying.
One of the key critiques of the proposals before they were funded was a balancing problem:
Experts told the transportation commission that Millersburg wasn’t far enough from Washington seaports to make rail cost-effective and that it would need the cooperation of two major railroad companies to ensure deliveries and a steady supply of empty containers to transport agricultural goods.
This is
like public rental bikes and rebalancing them so every station has enough! The
bikes, and containers, need to be circulating and can't pile up at the
end of one-way trips. Sometimes people have to drive around in trucks to pick up bikes and deliver them to empty hubs. That's an actual cost of the business that has to be budgeted in.
Apparently
boosters for the intermodal centers just assumed the balancing would
happen like magic, and did not make sufficient provision for active
balancing in their logistics analysis and budgets.
